Mobile Container Office
20-ft ISO · Built for 4–8 Work-Front Lifts on One Project
Crane-lifted between operating positions as the work front advances. Reinforced corner castings, welded roof brace, and lifting-point service kit factory-fitted for repeat lifts on the same project.
Size / Capacity
20×8 ft · 4–6 staff
Frame / Panel
IS 2062 · PUF panel
Price / Delivery
From ₹3,90,000 · 7–14 days
FloorLoad / Relocations
350 kg/m² · 4–8 lifts
Pan India delivery · 24-hr quote
+91 97089 89937
Description

A mobile container office is the right specification when one ISO container office must follow a single project’s physical work front through 4 to 8 operating positions across the project’s life — and the unit was built at fabrication to take that many crane lifts on the same site without losing alignment, weather seal, or electrical continuity. This page is for buyers committed to one unit on one active project — mining face progression, metro phase handovers, highway alignment shifts, transmission section work, dam phase work — where the office moves because the work itself moves.

When the Work Front Moves the Office: Three Project Signals and What Each Implies

A mobile container office is an ISO-grade shipping container office configured for repeated crane lifts within a single active project — typically 4 to 8 lifts across the project’s life, each move triggered by the work front advancing rather than by a calendar. The unit fits one project, one team, and one moving work zone.

Three project signals point to this configuration over a fixed unit, a fleet, or an inter-project unit.

Linear advance with a continuous work front. Highway alignment construction, transmission line erection, pipeline laydown. The office sits 1 to 3 km behind the active head and follows it forward every 8 to 12 weeks.

Phase-and-handover with discontinuous positions. Metro phase 1 closes and phase 2 opens 5 to 30 km away; dam work moves from cofferdam to main-dam to spillway. The office relocates between the hand-offs.

Sequenced campaigns within a defined civil-works zone. Mining face progression across a quarry, large industrial site phase development. The unit moves shorter distances more often.

Project typeTypical operating positionsTypical weeks per position
Highway / expressway alignment build4 to 68 to 12
Metro / urban rail phase build3 to 510 to 14
Mining face progression campaign6 to 86 to 10
Transmission line / pipeline section5 to 76 to 8
Dam / hydro phase work3 to 412 to 16

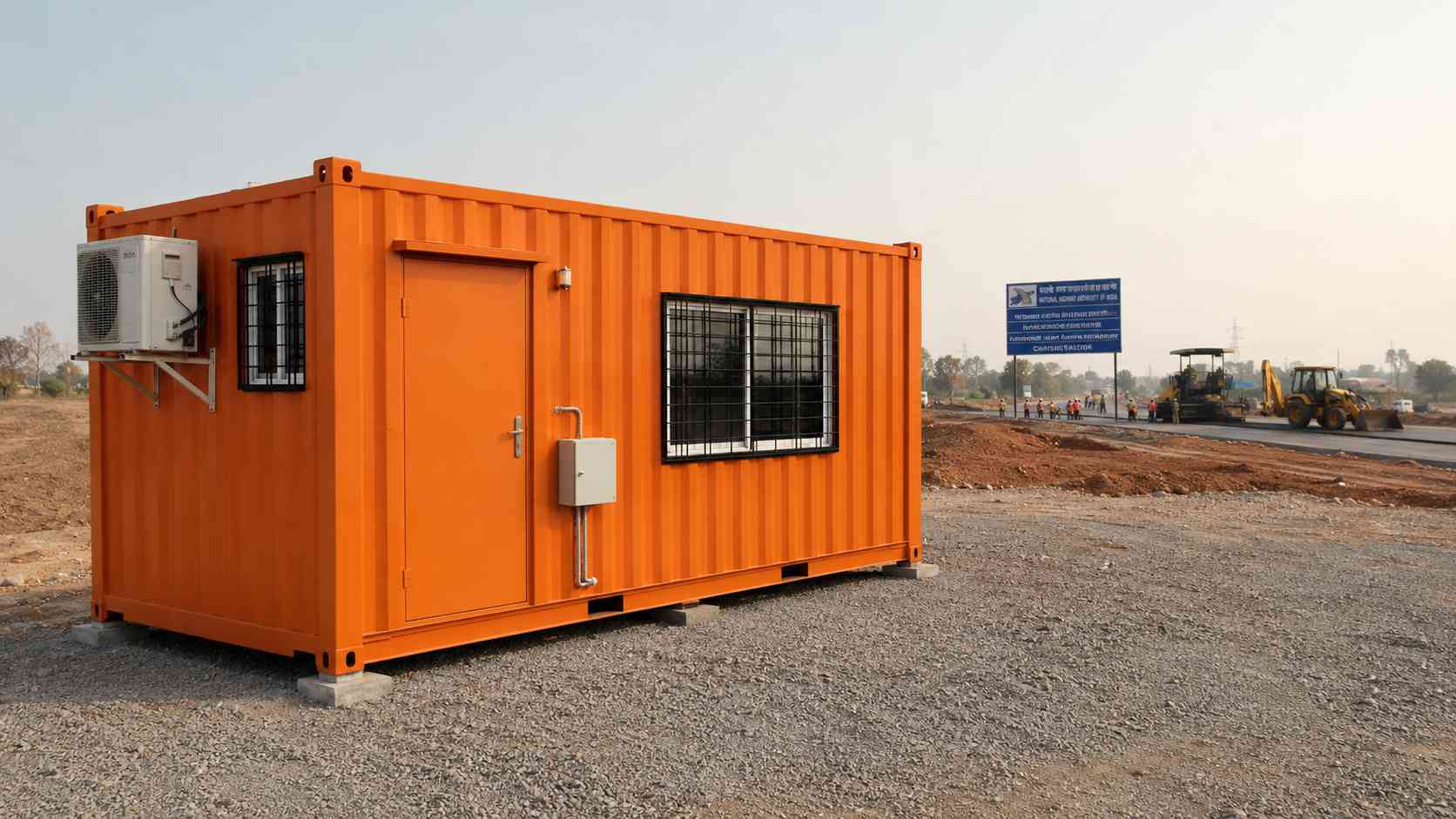

SAMAN mobile container office positioned behind an active Indian highway alignment construction work front.

SAMAN mobile container office at a highway alignment site — sits 1 to 3 km behind the advancing work front.

If your operations move by quarter or season across separate projects, our mobile office container page is configured for that pattern. For a fleet of three to seven units moving together, see our portable container offices range. For one unit redeployed across separate projects over five years, our container portable office page covers the lifecycle decisions.

The Crane Lift on a Live Project Site — ISO Castings, Spreader Bars, Forklift Pockets

An empty 20-ft container weighs around 2,250 kg. The same shell fitted with PUF wall panel, electrical conduit, AC provision, partition wall, and false ceiling weighs 4,500 to 6,000 kg. A fitted 40-ft unit crosses 8,500 kg.

The cuts for windows and doors weaken the corrugated wall panels that give an empty container its lift strength. Angled sling lifts then transfer inward force into walls that no longer carry it.

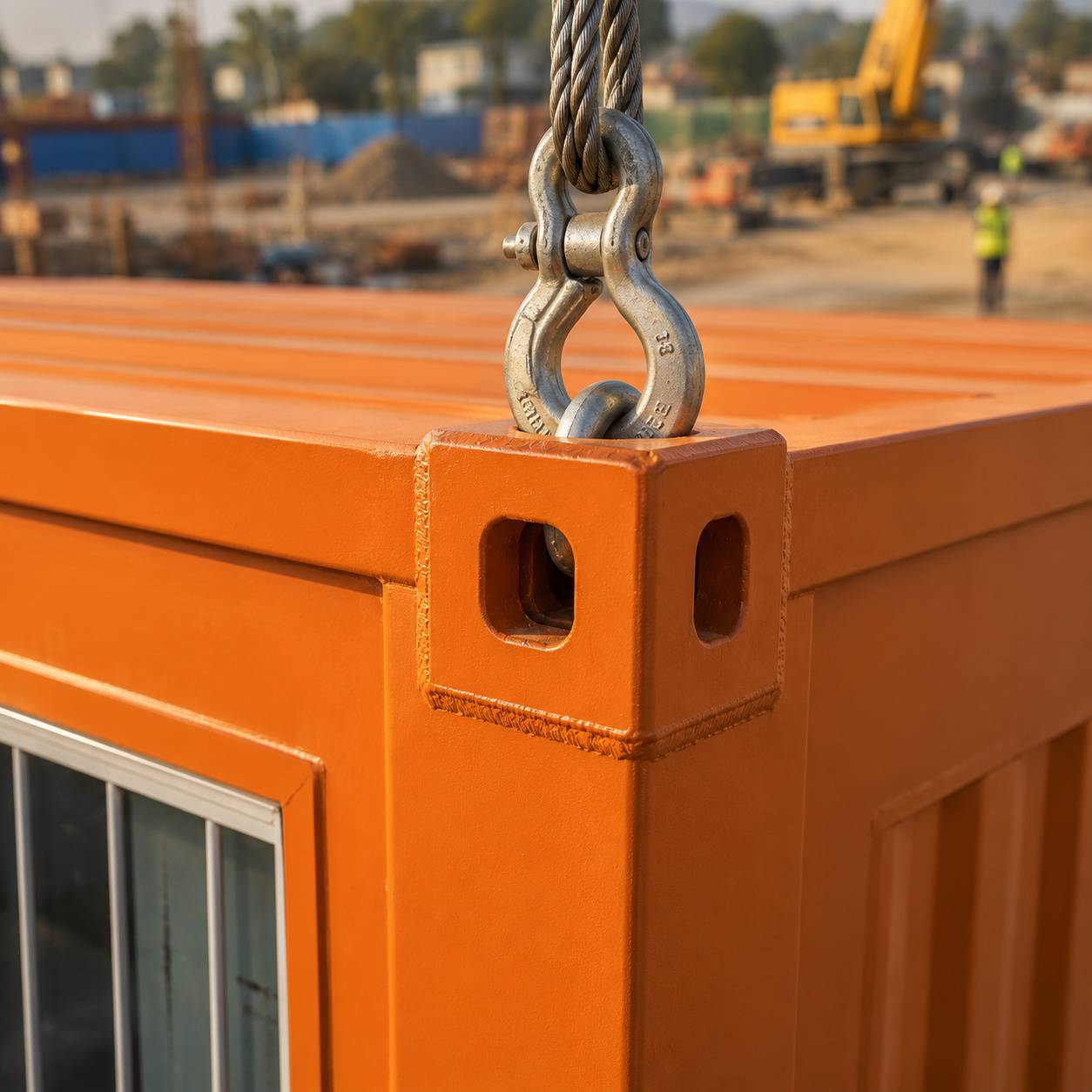

This is why a spreader bar is non-optional on a fitted unit. Slings drop straight down from the spreader’s ends to the four ISO corner castings — zero horizontal stress on the walls.

The top corner castings must remain unobstructed. SAMAN’s fabrication checklist holds back any design that buries them under cladding or architectural roofing. If your fitout calls for that, we lift from the bottom castings — 30 to 45 minutes more per lift in the rigging plan.

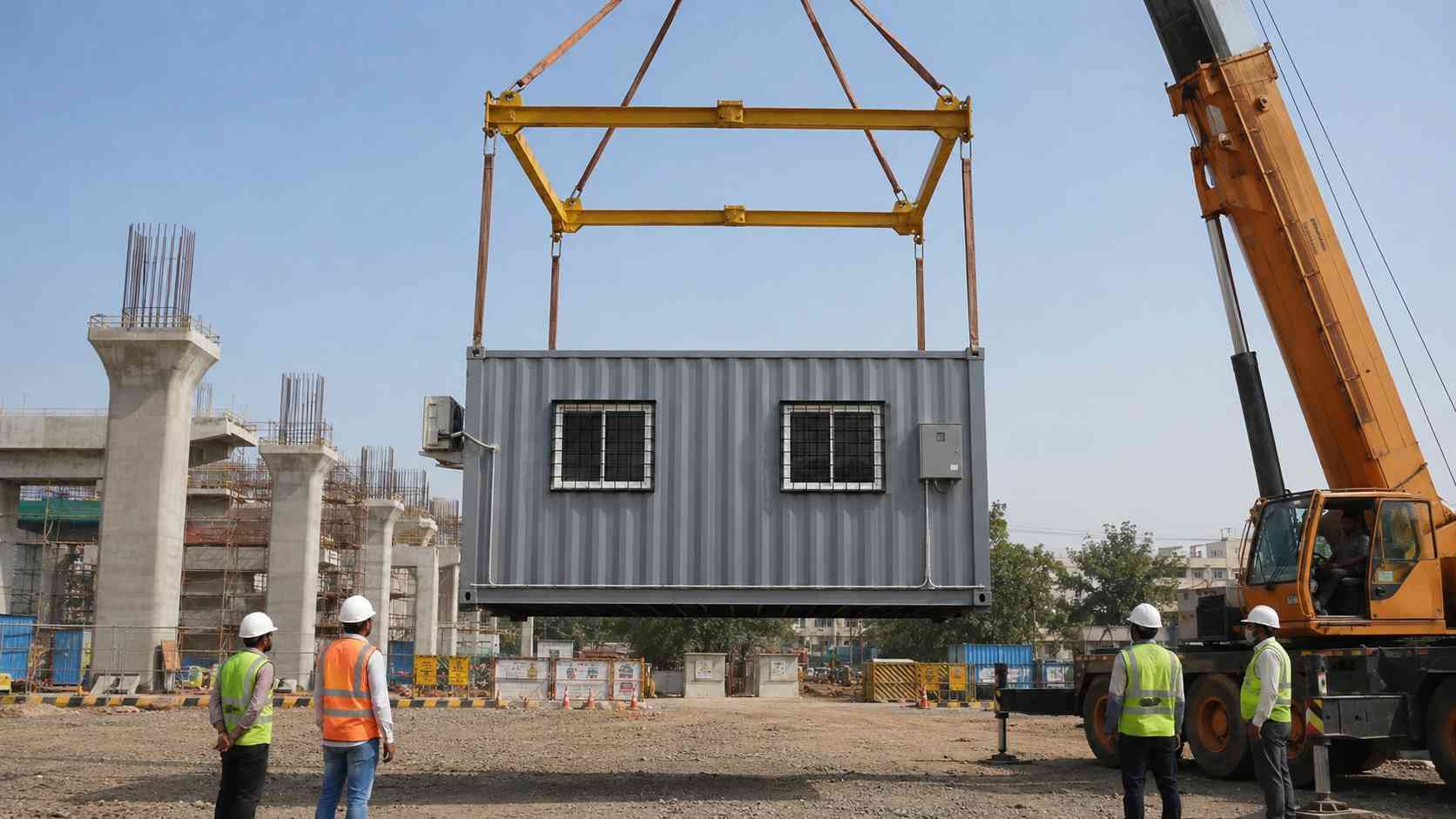

Steel grey SAMAN mobile container office being crane-lifted with spreader bar at an Indian metro construction site.

SAMAN mobile container office mid-lift between metro phase positions — spreader bar engages all four corner castings.

Forklift pockets work for empty or lightly fitted sub-15-ton 20-ft units only. A 30 to 60-ton mobile crane covers most Indian project sites. The rigging team at every lift is one crane operator, one boom guide, two ground crew, and a SAMAN supervisor for the first lift on each project.

Order-Stage Choices That Govern Lifting Performance Across the Project

Five fabrication decisions determine whether the unit takes 8 lifts cleanly or starts failing at the fourth. Each must be locked before dispatch — none can be retrofitted on site.

Reinforced corner casting weld. An extra weld pass at fabrication on all eight ISO castings — repeat-lift sites only. Adds about ₹6,000 to the unit price.

Lifting-point inspection schedule. The unit ships with a documented inspection cycle keyed to lift count. After every third lift, your site safety officer checks the four lift points against the supplied checklist.

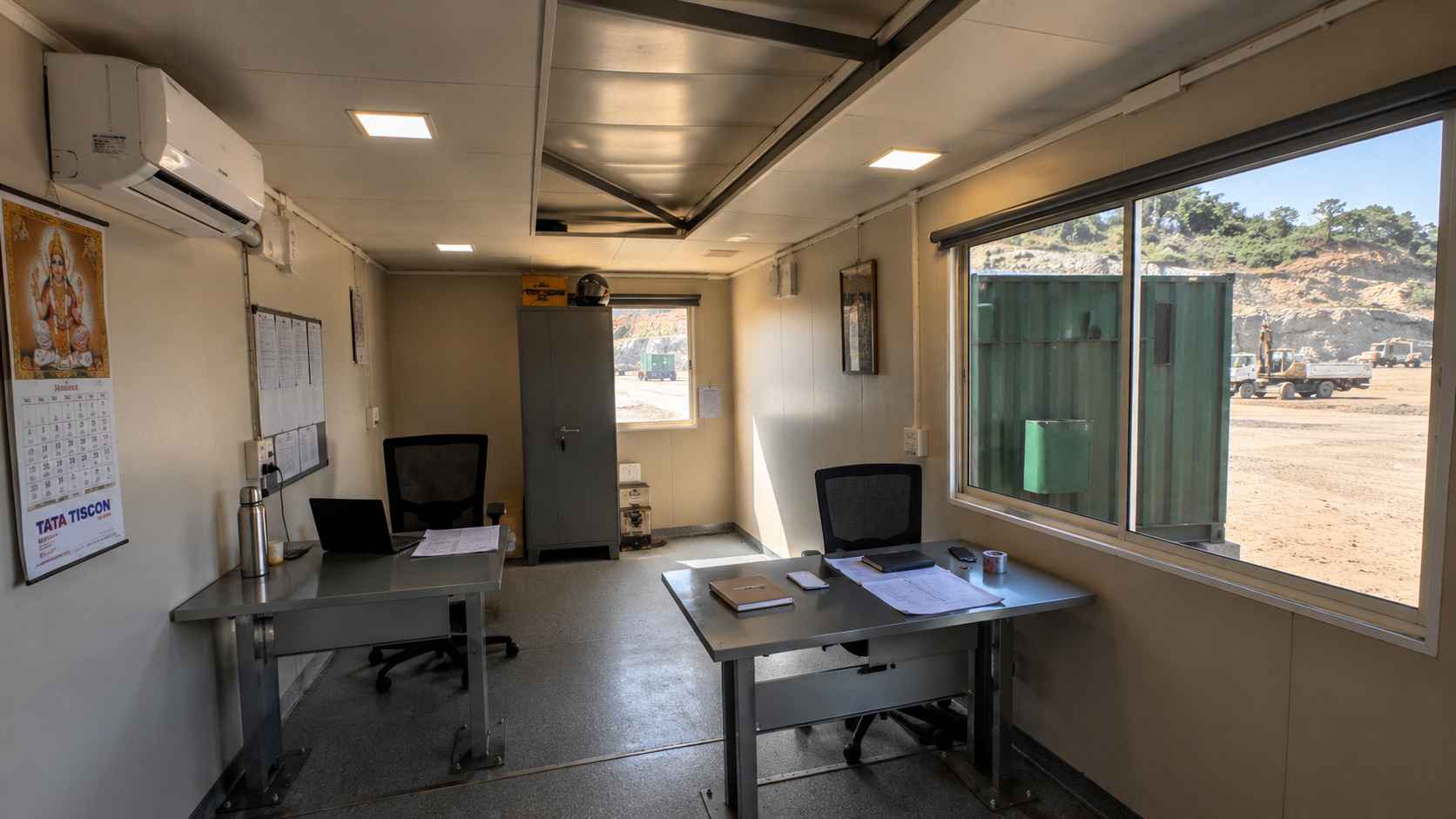

Interior of a forest green mobile container office showing anchored desks, detachable AC, and welded roof brace above.

SAMAN mobile container office interior — anchored desks and detachable AC mount, the order-stage choices for repeat lifts.

Anchored vs site-mountable elements. Desks and document cabinets bolted to the floor frame; AC, partitions, and ceiling fans on detachable mounts. The pack-down at every lift then takes two hours, not five.

Roof slope welded brace. Internal MS bracing welded at fabrication holds slope geometry across lifts; PUF panels alone flex under repeated rigging loads.

Door alignment shim plates. Pre-drilled at the hinge-frame interface for re-shimming after every two to three lifts.

One Lift Window on an Active Site — From Decommission to Re-Energised

A single work-front lift on an active project runs 6 to 14 hours total — usually inside one shift, occasionally a half-shift carryover. Short-haul, intra-project, on the same site safety regime.

Decommission (3 to 4 hours). MCB panel disconnects at the unit’s electrical inlet. Split AC switches off, brackets unbolt. Partition fixings drop. Detachable items pack into transit cases on the floor.

Crane window (1 to 2 hours). Site safety officer briefs your crew, the work zone clears for the lift sweep, the spreader bar rigs to the four corner castings. Lift to flatbed for short haul, or direct lift to the next levelling pad.

Short transit. Typical haul on the same project is 0.5 to 30 km. For an adjacent phase across project boundary, up to 80 km. No inter-state ODC permits.

Re-energise (2 to 3 hours). Levelling pad alignment check, MCB reconnect from the project’s electrical room, AC re-bolt, partition refix.

Total project downtime: one working day per lift.

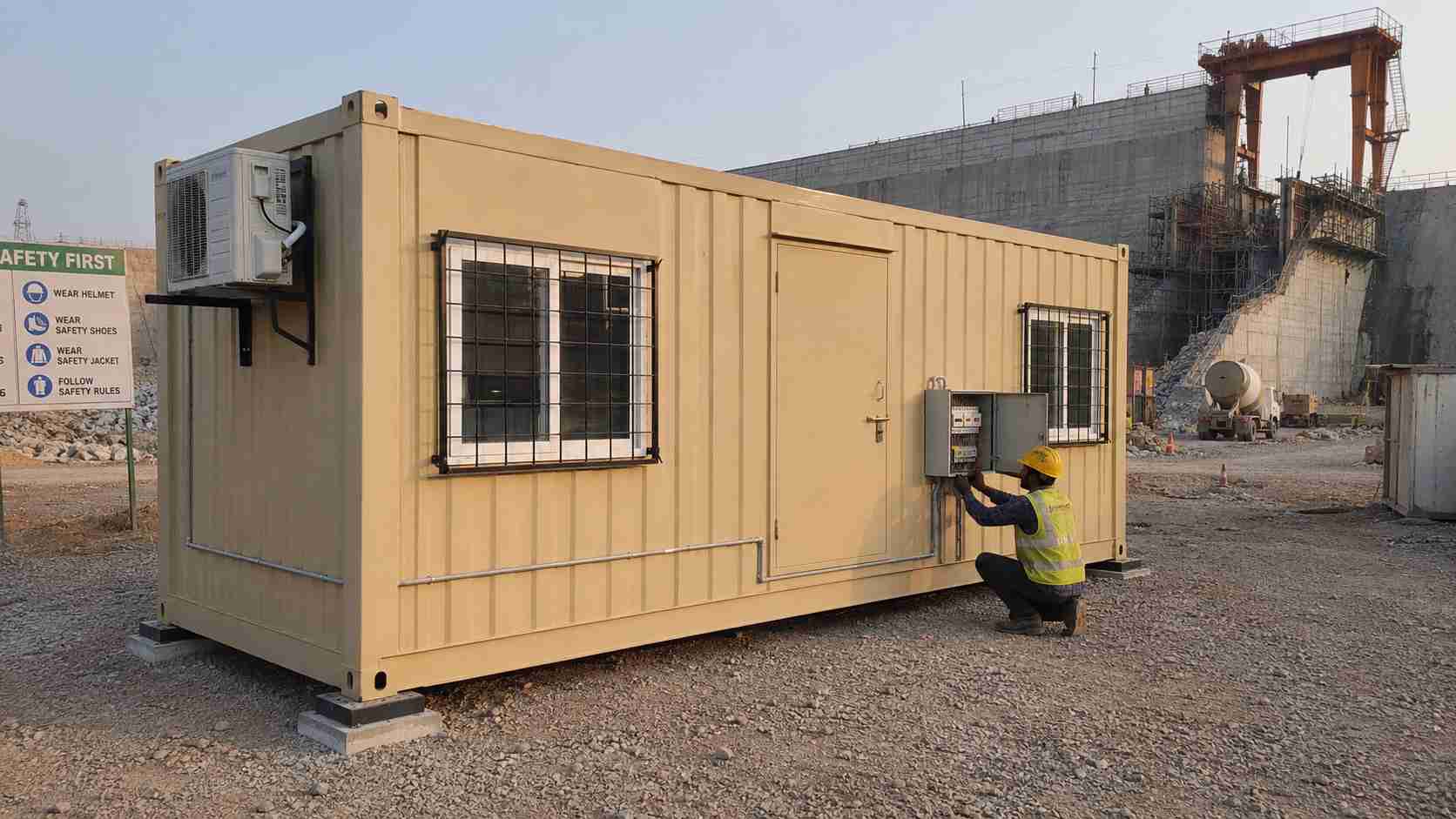

Sandstone beige SAMAN mobile container office during recommission at an Indian dam site, MCB panel being reconnected.

SAMAN mobile container office at dam project recommission — MCB reconnect, levelling pad alignment, AC remount.

Unit Price and What Each Work-Front Lift Adds to the Project Budget

A 20-ft mobile-spec unit starts at ₹3,90,000 — factory-fitted with corner casting weld upgrade, lifting-point service kit, AC provision, and electrical fitout. The 40-ft equivalent starts at ₹6,20,000.

What each work-front lift adds to the project budget on an active Indian site: ₹15,000 to ₹35,000 (mobile crane hire), ₹8,000 to ₹15,000 (re-shim and anchoring labour), ₹4,000 to ₹8,000 (MEP reconnection). Single lift typical band: ₹30,000 to ₹55,000 — meaningfully lower than the ₹35,000 to ₹1,20,000 a calendar-driven inter-state move costs.

A 20-ft unit moved across 6 operating positions on a 24-month project carries ₹2.0 to ₹3.5 lakh in lift costs on top of the unit price. For the full container office range and category-level procurement guidance, see our container office hub.

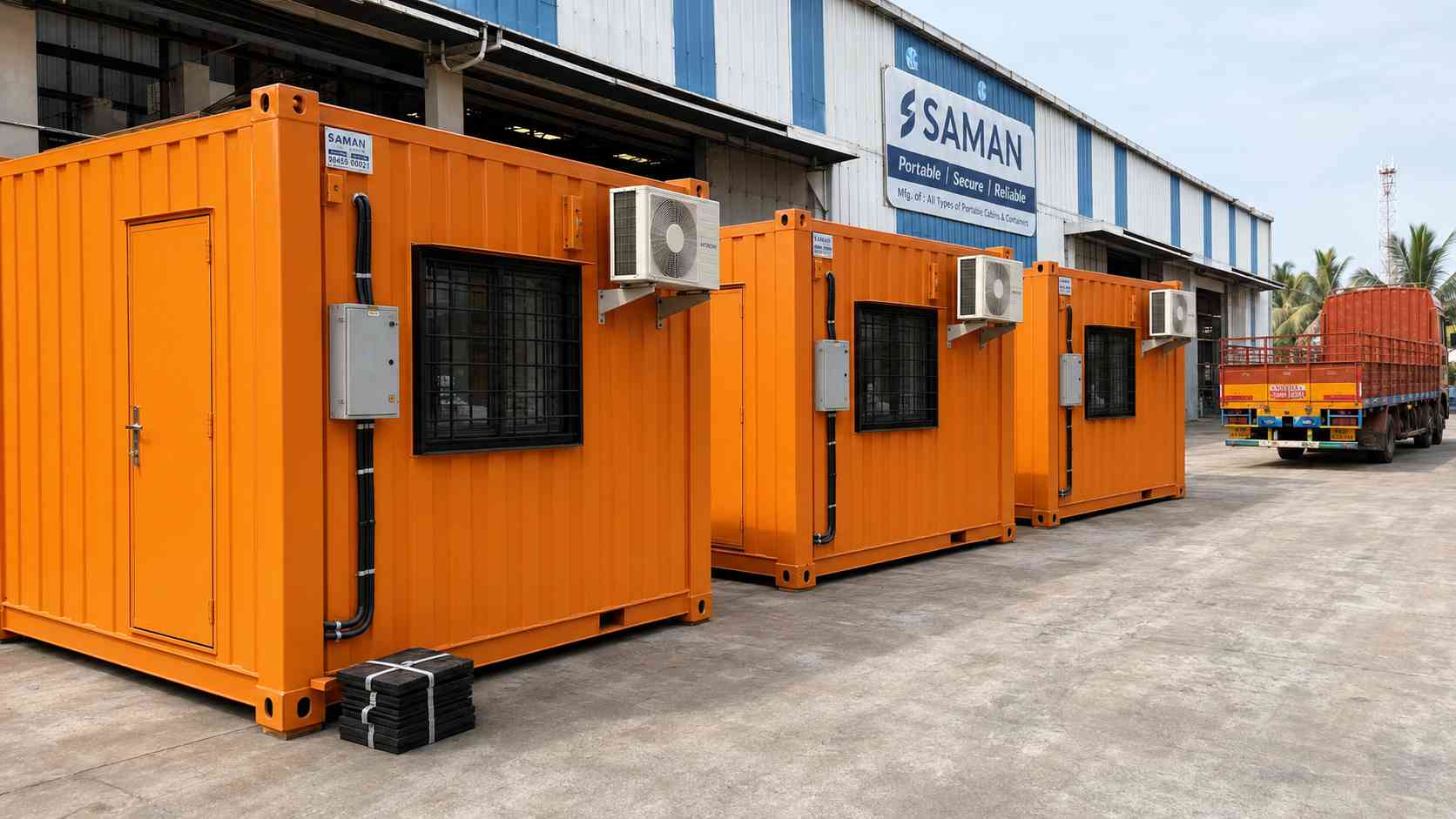

Three safety orange SAMAN mobile container offices ready for Pan India dispatch from a Bangalore factory yard.

SAMAN mobile container offices ready for Pan India dispatch — manufactured at our Bangalore and Greater Noida facilities.

Specifying a Mobile Container Office for Your Project

Send us five inputs and we respond with an itemised quote within 24 hours.

  • Project type: highway, metro, mining, transmission, dam, or other
  • Expected number of operating positions across the project’s life
  • Longest single haul between two operating positions
  • Base unit count (this page covers single-unit specifications)
  • Required first-position commissioning date

Manufactured at our Bangalore and Greater Noida facilities. Delivered and erected Pan India in 7 to 14 working days for single-unit mobile-spec.

Call or WhatsApp: +91 97089 89937

Frequently Asked Questions

How many crane lifts can one unit take on the same project before a structural service is needed?

Mobile-spec units with reinforced corner casting welds and a welded roof brace are rated for 10 to 12 lifts before a factory structural service is recommended. The supplied lifting-point inspection checklist tracks the count. We schedule the service at 10 lifts or 24 months from dispatch, whichever comes first. Standard fitout units are not recommended past 4 lifts.

Do we always need a crane, or can a forklift handle short intra-site moves?

A forklift works for empty or lightly fitted sub-15-ton 20-ft units, on hard level ground, with a heavy-duty forklift rated 18 tons or more. Once the unit is fitted with AC, partitions, and false ceiling, forklift lift is unsafe — a 30 to 60-ton mobile crane is the right tool.

What changes when the office is lifted with the AC, partitions, and false ceiling already inside vs an empty container?

Three things. Weight rises from ~2,250 kg to 4,500–6,000 kg on a 20-ft unit. The corner castings carry a fitted load that flexes the walls under angled slings — making a spreader bar non-optional. And every interior fixing must hold the dynamic load of the lift, which is why the order-stage anchoring decisions matter.

Can the unit be lifted from bottom corner castings if the top castings are obstructed by architectural cladding?

Yes. Bottom-casting lifts use a longer chain or sling kit and add 30 to 45 minutes to the rigging cycle. We confirm the method at the order stage so the rigging plan ships with the unit. Bottom-only lifts suit fitouts where architectural roofing crosses the top castings.

Can the same unit then be redeployed to a different project after this one closes?

Yes — but post-project redeployment is a different specification from intra-project lifts. Inter-project moves are one or two long hauls across five years with a different fitout discipline. Our container portable office page covers that lifecycle.

What does a single work-front lift typically cost on an active Indian project site?

₹30,000 to ₹55,000 for a 20-ft unit on intra-project lifts up to 30 km. Crane hire is the largest line — ₹15,000 to ₹35,000 depending on tonnage. Re-shim and MEP reconnection adds ₹12,000 to ₹23,000. Inter-state moves cost more and need ODC permits for 40-ft units.
